Progress of the Outstanding Construction Works of the Library Extension & Revitalisation (LER) Project
Outstanding Construction Works |
Planned Construction Period |
Completion Status |
IAQ works |
Aug 2020 – Apr 2022 |
To be completed in synchronization with building works on various floors. |
P/F Installation of automatic book return station |
July – Aug 2022 |
In Progress |
G/F South Wing |
Dec 2021 – early Apr 2022 |
To be completed when books on temporary bookshelves can be relocated to the renovated 3/F |
G/F North Wing |
May – Aug 2022 |
In Progress |
3/F South Wing |
May – Aug 2022 |
In Progress |
3/F North Wing |
May – Aug 2022 |
In Progress |
P/F and main entrance |
May – Oct 2023 |
|
Please allow some time for defects rectification and furniture installation after completion of construction works.
For enquiries about progress of construction works, please contact Project in charge of the Campus Development Office, Mr. John Lai at Tel.: 2766-7887 or CDO Hotline: 2766-7766, Email: cdinfo@polyu.edu.hk.

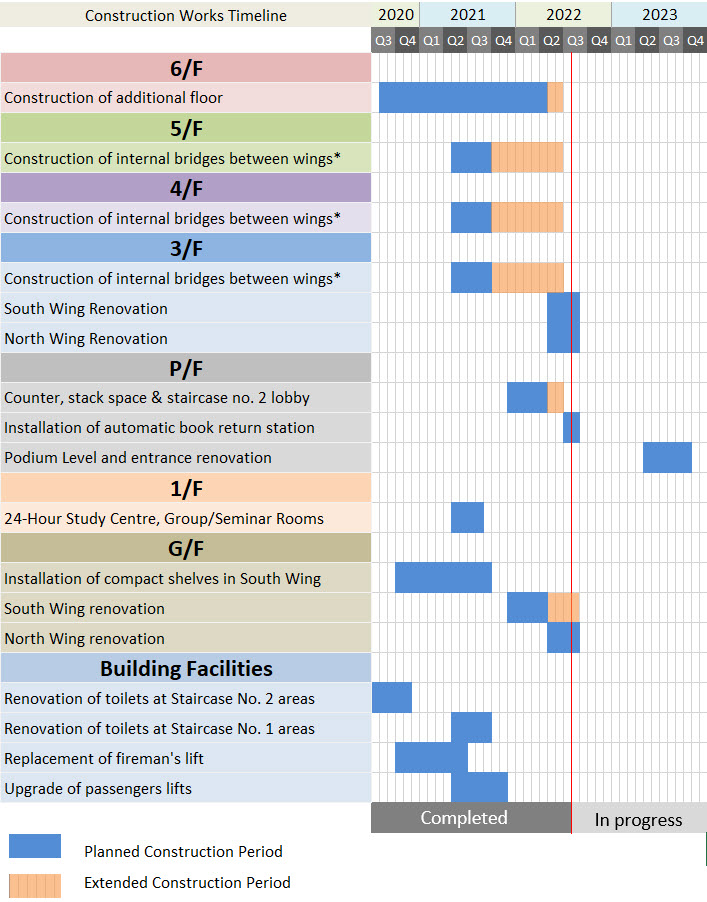

Timeline
Major noisy works will be suspended during revision & examination period.
